How to Build a Dry Stack Big Block Retaining Wall

A dry stack wall has no mortar. It holds soil back with mass, friction between courses and a deliberate lean into the hill. Almost every failure you will ever see comes from the two parts nobody photographs: the levelling pad underneath and the drainage stone behind.

Published Updated 11 min read

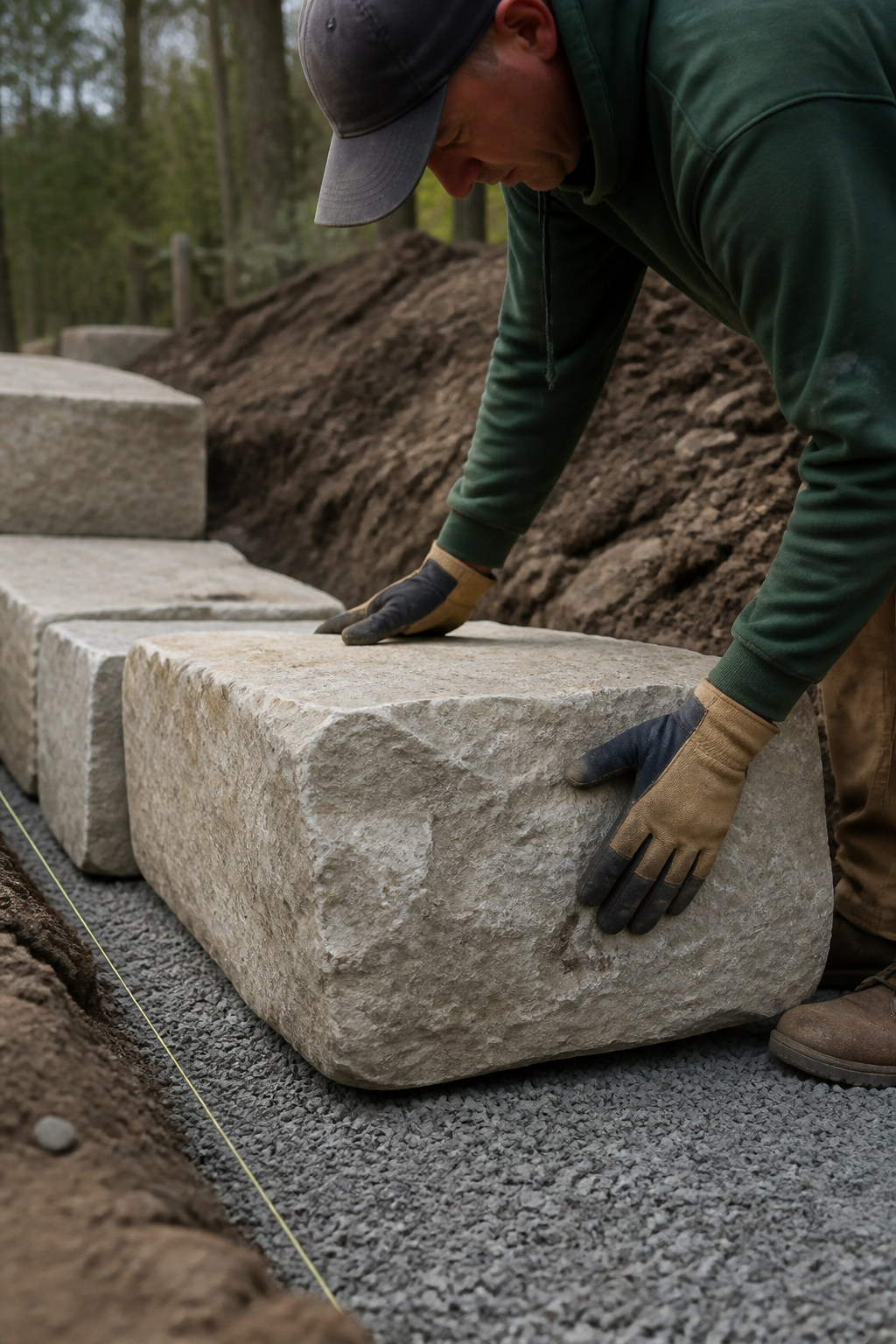

Worker setting a large concrete block onto a levelled crushed stone base while building the first course of a dry stack retaining wall
The first course is the slow one. Every millimetre of error here is repeated in every course above it.

A big block dry stack wall is a gravity wall. Nothing glues it together. It stays where it is because each course is heavy, because the blocks grip each other, and because the whole face leans back into the slope it is holding. Get those three things right and the wall is close to maintenance free. Get the base or the drainage wrong and it will lean, bulge or slide, usually in its second or third spring.

What dry stack really means

Dry stack
Laid without mortar. Units bear directly on one another, and the joints are free to move a little rather than crack.
Big block
Large segmental retaining wall units, usually machine set, weighing far more than a hand-laid block. The extra mass is what lets a bigger wall stay a gravity wall for longer.
Setback (or batter)
The backward lean built into the units. A lip, a pin or a bevelled face makes each course sit slightly behind the one below.
Reinforced wall
A wall that needs layers of geogrid buried in the backfill because gravity alone is no longer enough. That is an engineered structure, not a weekend project.

Segmental retaining walls have their own body of design guidance in the United States, published by the National Concrete Masonry Association. Any manufacturer worth buying from publishes an installation sheet built on it, and that sheet always beats a generic guide, including this one, because it is written for the exact geometry of the unit in your hands.

Height, permits and the 811 call

Two questions come before any tool comes out of the truck.

  • How tall, measured from the bottom of the base to the top of the last block? Many jurisdictions require a permit and a design signed by an engineer once a wall retains more than four feet of unbalanced fill. Some set the trigger lower. The number is local, so ask your building department before you buy blocks.
  • Is anything sitting on top of the soil you are holding? A driveway, a parking pad, a pool, a slope continuing uphill, or another wall above this one all add what engineers call a surcharge. Surcharge changes the maths at any height, including walls under four feet.

Then call 811. It is the national number for locating buried utilities in the United States, the service is free, and the marks arrive within a few working days. The paint on your lawn is cheaper than a struck gas line by a margin no one needs explained.

The levelling pad

The pad is a compacted trench of crushed stone that spreads the wall load and gives the first course something rigid and flat to sit on. Common practice for big block work is a pad about six inches thick after compaction, running at least six inches wider than the block on both the front and the back.

Excavate to firm, undisturbed soil. If the trench bottom is soft, wet or full of topsoil, keep going until it is not, then make up the depth with more stone rather than with the soil you removed. Compact the stone in shallow lifts with a plate compactor, not by walking on it.

The first course is usually buried. The common rule of thumb is one full block, or about ten percent of the finished wall height, with a practical minimum of six inches. That buried course is what stops the wall being pushed out at the toe.

Setting the first course

This course takes as long as the next four put together, and it should. Work to a string line, set each block, then check level along the block and across it, front to back. A block that rocks is a block that will rock forever, because there is no mortar to bed it. Lift it, adjust the stone underneath, set it again.

Every error in the first course is copied upward, then amplified by the setback.

The reason experienced crews spend half a day on one row

Drainage: the invisible half

Soil is heavy. Saturated soil is much heavier, and it pushes. A retaining wall that has no way to let water out is being asked to hold a load it was never sized for. This is the part homeowners skip, and it is the part that fails.

  • A zone of clean, angular drainage stone directly behind the blocks. Twelve inches is the figure most manufacturers give as a minimum. Angular stone locks together and stays open; rounded pea gravel does neither.
  • A perforated drain pipe sitting at the base of that stone, laid with fall, and taken to daylight or to a positive outlet. A pipe that ends in the middle of the backfill is decoration.
  • A geotextile separation fabric between the drainage stone and the native soil, so fines cannot wash into the stone and clog it.
  • Surface water sent somewhere else. Downspouts and swales that discharge above a retaining wall will find the one weak spot every time.

Setback, backfill and compaction

Each course goes back a set amount. On many big block systems the geometry works out near an inch per course, but the unit decides it, not a rule of thumb, so read the sheet that came with the pallet. Sweep the top of each course clean before setting the next one, because a single stone chip left under a block is enough to tip it.

Backfill in lifts of six to eight inches and compact each lift before adding the next. Within about three feet of the wall face, switch to a lighter compactor or a hand tamper. A big machine run tight against the back of the blocks is one of the few ways to push a well-built wall out of line during construction.

The three specifications that decide the wall
Element What it is Common practice What happens if it is skipped
Levelling pad Compacted crushed stone under the first course About 6 in thick, 6 in wider than the block front and back Settlement, then a wavy face and open joints
Drainage zone Clean angular stone plus perforated pipe behind the blocks At least 12 in of stone, pipe taken to daylight Water pressure builds, the wall leans or bulges
Compacted backfill Soil placed and compacted behind the drainage zone 6 to 8 in lifts, light equipment near the face The ground behind the wall sinks and cracks

Caps and the finished top

Cap units are normally bedded on a flexible concrete adhesive rather than mortar, so the top can move with the wall instead of cracking off it. Finish the ground behind the cap so surface water runs away from the wall rather than over it, and keep soil below the top of the cap so nothing washes across the face.

If the top of the wall is walked on, treat the edge the way you would treat any drop: guarding requirements are a code matter and they depend on height and on what is above.

When to stop and hire an engineer

Call someone with a stamp when any of the following is true, whatever the height.

  • The wall retains more than the local trigger height, commonly four feet of unbalanced fill.
  • There is a driveway, a slab, a pool or a structure within a wall height of the top.
  • The ground continues to rise behind the wall instead of levelling off.
  • You are stacking walls in tiers, which behave as one taller wall unless they are far enough apart.
  • Water collects there, or a spring or seep shows up during excavation.

What upkeep actually involves

Almost nothing, if the drainage works. Once a year, check that the drain outlet is still open and not buried under mulch, look along the face for any course that has moved out of line, and clear plants whose roots are heading into the joints. A wall that stays straight for three winters will usually stay straight.

Once the wall is done, the surface next to it usually is not. If a patio or path meets the wall, the same principles apply to the paving: base first, edge restraint always. That is covered in the guide to cleaning brick pavers without wrecking the hardscape, which explains why joint sand is structural and not cosmetic.
